When the final putaway is done for material for inbound delivery, there can be a need to take the reverse of the goods receipt. It is possible to reverse goods receipt even if the final putaway is done whether the material has an HU or not by defining a delay duration via Correction of Confirmation with a related exception code.
Maintain the configuration settings necessary to perform a delayed delivery update.

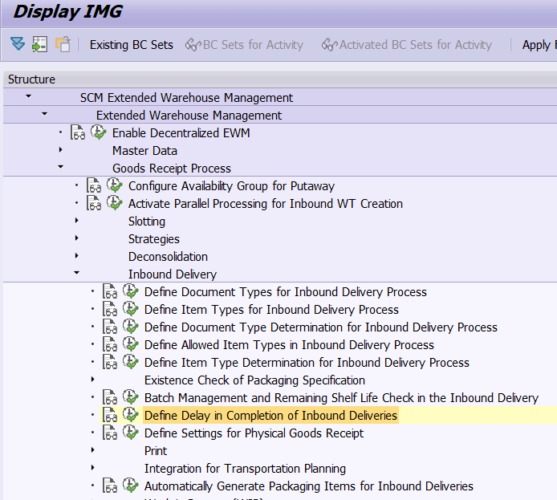

a. In customizing for SCM Extended Warehouse Management, go to Extended Warehouse Management → Goods Receipt Processes → Inbound Delivery → Define Delay in Completion of Inbound Deliveries
b. Choose New Entries.
c. Enter the related Warehouse Number in the Warehouse Number field.
d. Enter INB in the Document Type field.
e. The deliveries which have the same document type can be separated based on Item Type but in our case, it will not be used.
f. Choose Relevance at Header Level for Status Relevance.

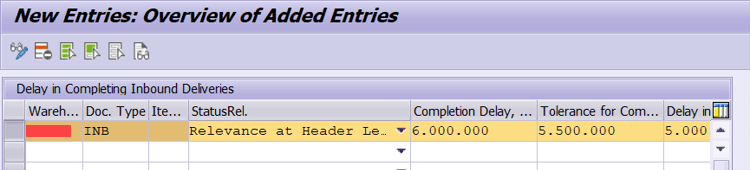

g. Enter your time frame for the Completion Delay field, Tolerance for Completion Delay field, and Delay in Job Rescheduling for Setting DWM Status
h. Choose Save.
a. In customizing for SCM Extended Warehouse Management, go to Extended Warehouse Management → Cross-Process Settings → Exception Handling → Define Exception Codes
b. In the Create Exception Codes segment, choose New Entries.

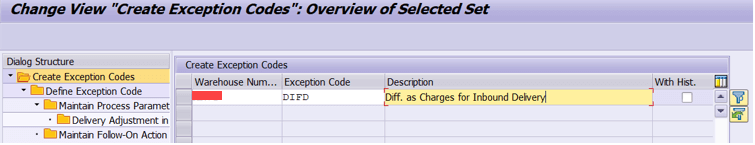

c. Enter Warehouse No., Exception Code DIFD, and the Description as Charges for Inbound Delivery.
d. Choose Save.
e. Choose the entered row and open the Define Exception Code segment.
f. Choose New Entries.

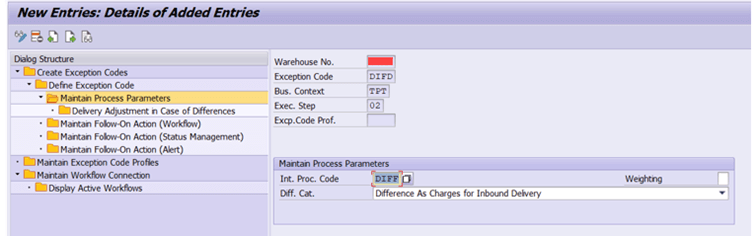

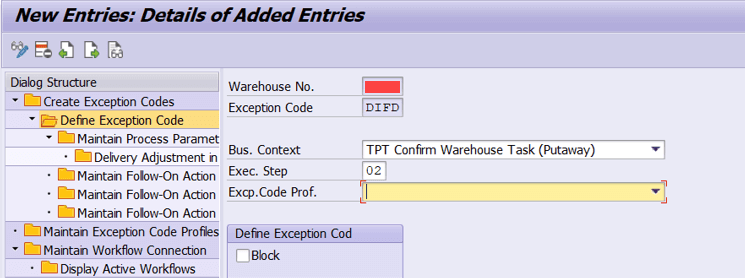

g. Enter Business Context TPT Confirm Warehouse Yask(Putaway), Exec. Step 02 (Desktop Product Warehouse Task).
i. Open the Maintain Process Parameters.
j. Choose New Entries.
k. Enter Int. Proc. Code DIFF and press enter.
l. Select Diff. Cat. Difference As Changes for Inbound Delivery.
m. Choose Save.
n. Open the Delivery Adjustment in Case of Differences.
o. Choose New Entries.

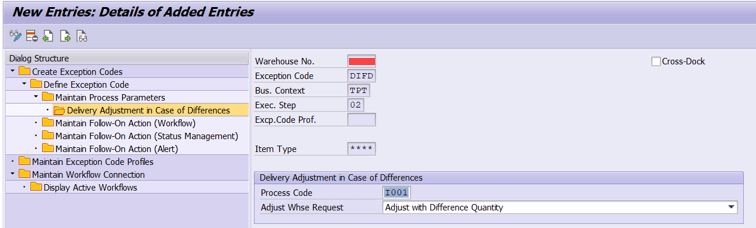

p Enter Item Type ****, Process Code I001, select Adjust Whse Request Adjust with Difference Quantity, and Save.
a. In customizing for SCM Extended Warehouse Management, go to Extended Warehouse Management → Cross-Process Settings → Delivery-Warehouse Request → Status Management → Define Status Profiles.

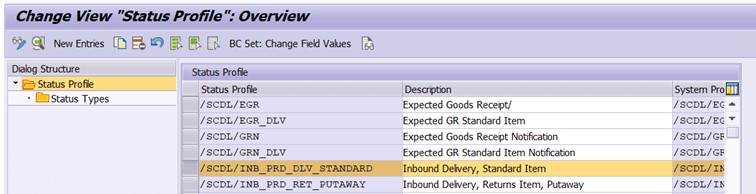

b. Choose the related Status Profile that is used for the Item Type for Inbound Delivery Process. In this scenario, /SCDL/INB_PRD_DLV_STANDARD which represents standard item for inbound delivery is used.
c. Open the Status Types segment.

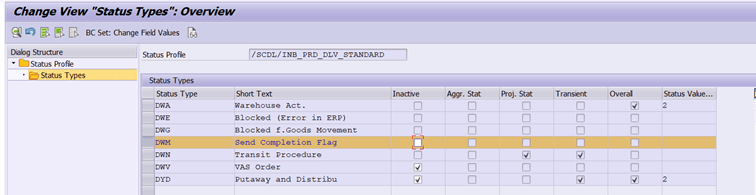

d. Remove the ‘Inactive’ column’s click for DWM Status Type.
e. Choose Save.

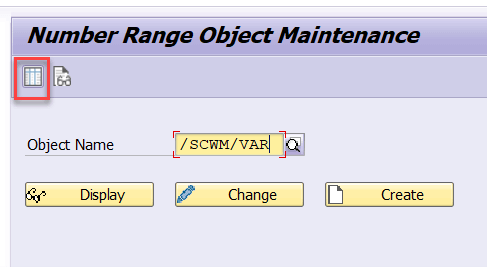

a. Enter T-Code: SNRO.
b. Enter Object Name /SCWM/VAR.
c. Choose Internal Editing.

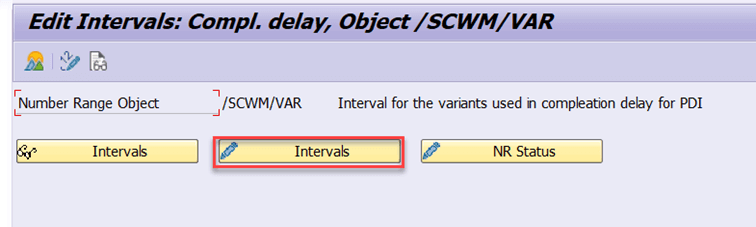

d. Choose Edit Invervals

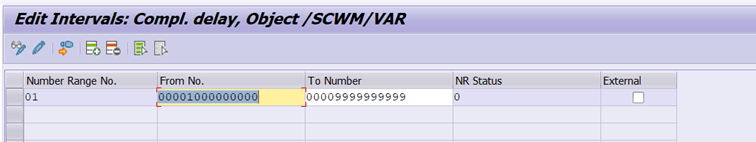

e. Enter Number Range 01, From No. 00001000000000, To Number 00009999999999.
Reverse a goods receipt by correction the confirmation and updating the delayed delivery items without HU.

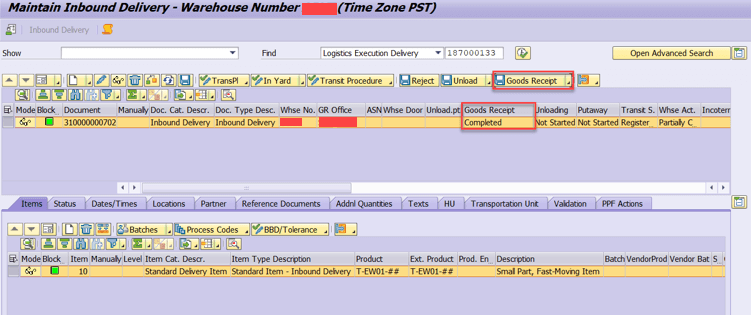

a. Open the EWM inbound delivery document, choose the Goods Receipt, and check whether the Goods Receipt status turns into Completed

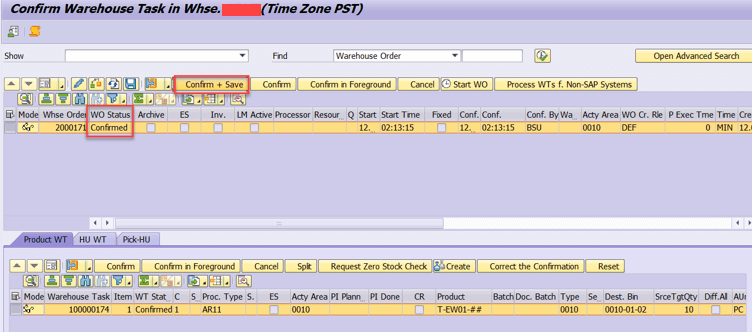

b. Create and Confirm a warehouse task for final putaway.

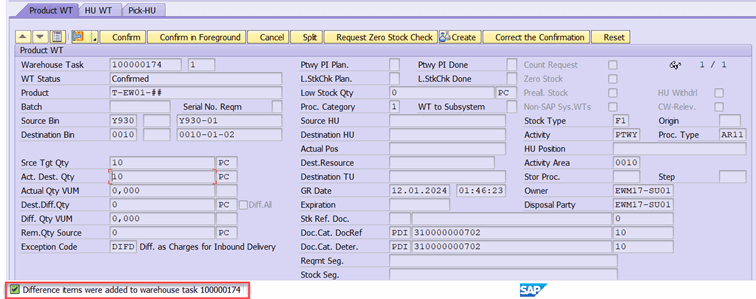

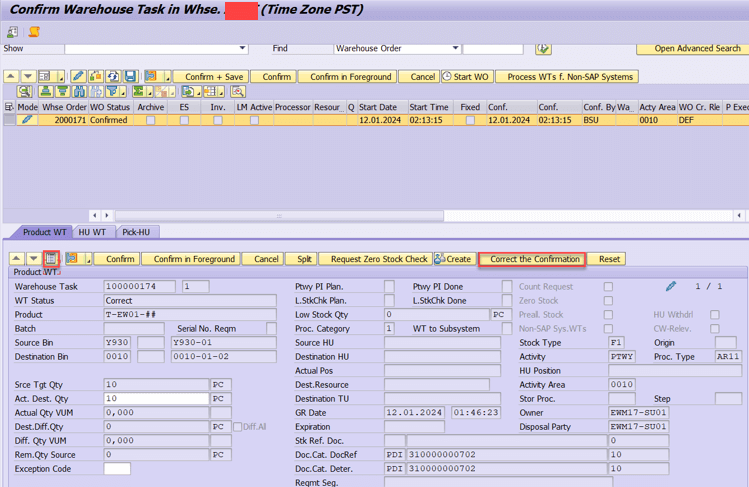

c. On the same screen, choose Correct the Confirmation and open the Product WT in a Form View.

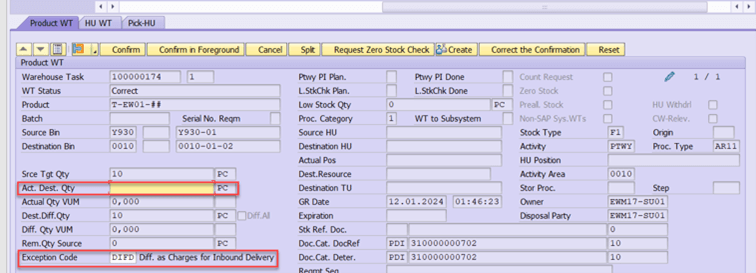

d. Delete the Act. Dest. Qty and enter Exception Code DIFD

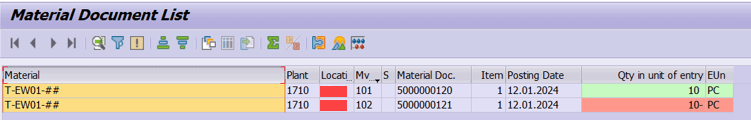

f. Check the Material Document List for the material T-EW01-##. It shows the reverse goods receipt movement typ
SAP EWM Consulting
SAP EWM Consultant
What is Handling Unit?
Definition of Handling UnitA handling unit is a physical unit made up of the packaging materials and the commodities that are enclosed within it. A...
How to Use SAP EWM to Automate Warehouse Management Tasks
As SAP will end support for WM by 2025, many businesses are planning to migrate their warehouse operations to SAP Extended Warehouse Management. At...
Exploring SAP Intelligent Scenario Lifecycle Management (ISLM)
What is SAP ISLM? SAP Intelligent Scenario Lifecycle Management (ISLM) is a SAP solution designed to streamline the lifecycle of artificial...
The Transition Process from SAP ECC to SAP S/4HANA
Enterprise Resource Planning (ERP) is a system whose solutions are designed to enable businesses to manage their basic operations with a software....
Expected Goods Receipt Process in SAP EWM
Introduction Expected Goods Receipt (EGR) is one of the vital functionalities in SAP Extended Warehouse Management (EWM), ensuring the smooth...
What is SAP Signavio Process Insight?
SAP Signavio Process Insight is one of the core solutions of the SAP Signavio Process Transformation Suite, designed to help companies improve their...
What is SAP Leonardo?
Everything You Need to Know About SAP's Leonardo PlatformSAP Leonardo is an innovation platform offered by SAP that can work with blockchain, IoT,...
Slotting Process in SAP EWM
What is SAP EWM? SAP Extended Warehouse Management (SAP EWM) is a warehouse management solution that includes additional functions to the SAP WM...
RAFT: Why Your Time Series Model Needs a Memory
Time series forecasting has been dominated by increasingly complex architectures. From CNNs to RNNs, from Transformers to MLP-mixers, we've thrown...
Your mail has been sent successfully. You will be contacted as soon as possible.
Your message could not be delivered! Please try again later.
